PROJECT #1 Building the hillside roadway
Architect: KR enterprises inc.
Est.Cost: 23 mil
ETA: 288 days
Contractor: KCC company
Sub-Contractors: Malcolm Drilling, SUKUT earthmoving, JC concrete, All American Asphalt

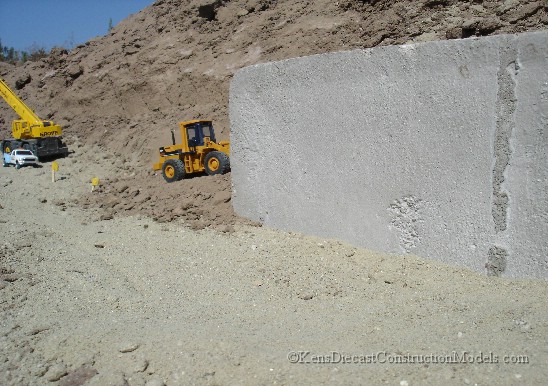

Photo of the earth leveling process. The soil being extremely dense hydraulic
excavator mounted breakers had to be brought in to loosen the rock. The rough
soil made it hard for graders to keep up on clearing the roadway for the
dump trucks so that created some drawback
The LIEBHERR 984 was used 10 hours a day loading articulated dump trucks to
bring the hillside down to the level needed for smooth daily driving
The loaded articulated dump trucks were taken to low spots in the
planned roadway to bring them up to a more levelized point (984 shown
here loading the trucks in 3 scoops or less)
Before the 984 on a higher section of the hillside a CAT 5080 front
shovel was used do bring the hillside down to a smaller size, 2 CAT
ripper dozers above loosen rough dirt and push down for 5080 to scoop up
Heres a better pic to show off the dozers used above supplying the
5080. If you notice it is a 3 staged process used in bringing down the
hillside to the desired level. First the dozers are used above creating
the first level, then the 5080 is used to create a secong level (which the
984 sits on as well), and then the 984 creates the third final level. Not
to mention the CAT 245 hydraulic breaker used whenever necessary on all levels
This was a picture taken to show how the graders ( 2 caterpillar 140H's )
couldn't keep up with the roughness of the dirt on the dump truck trail
Here is one of the lower spots in the planned roadway that needed to have
dirt added so the loaded articulated trucks dumped there loads in these
specified areas
Beacause of the dirts roughness after all the earthmoving was complete a
8 inch layer of sand sediment was brought in and leveled out as a base
for the roadway
Since landslides are a reality retaining walls had to applied to some areas
of the roadside.
Malcolm drilling company was brought in to drill between 15 feet and 30
foot deep piling holes (depending on the area and wall size needed)
Temporary supports were added to support concrete moldings
Wood sheets were craned into place to create a concrete molding
behind the temporary supports
Pic of the concrete pumper in place waiting for the concrete trucks
arrive. (This particular wall segment was approx. 7 trucks, varies on
segments throughout roadway)
After the concrete was dry (waited 5-7 days for correct hardyness on
wall size) the temporary supports were removed along with the moldings
A mixed gravel aggregate was applied as backfill to alliminate erosion
and create correct soil drainage
Finally All American Asphalt was called in and the asphalt was layed into
place and the street lines were painted ready for trafic. Completed and opened
in 302 days (approx. 2 weeks behind scheduled)
